Clothing Production Timeline: Why Your Collection Takes 18 Months to Launch (And How to Plan for It)
Most new clothing brands start production six months too late because the clothing production timeline takes far longer than it looks from the outside. If you want your Fall/Winter collection on shelves by September, you need to start designing in January of the previous year. This guide breaks down every stage of the process so you can plan for a successful launch.
If you want your Fall/Winter collection on shelves in September, you need to start the design process in January — of the previous year. That's 18-20+ months of lead time for a major seasonal launch.
For independent brands, missing this window means arriving after the trend has peaked, sitting on dead inventory, and funding a second production run you can't afford. This guide breaks down the complete clothing production timeline stage by stage.
Why Clothing Production Takes Longer Than You Expect
Apparel manufacturing operates on a fundamentally different rhythm than other industries, built around:
- Global supply chains: Fabric sourced in one country, cut and sewn in another, shipped to a third.
- Physical sampling cycles: Constant back-and-forth between designers and factories.
- Seasonal buying calendars: Retailers lock in orders 6–12 months in advance.
- Trend windows: These open fast and close even faster.
The industry runs on a 12–18 month planning horizon. If you're planning on a 3–4 month timeline, you're building in failure.

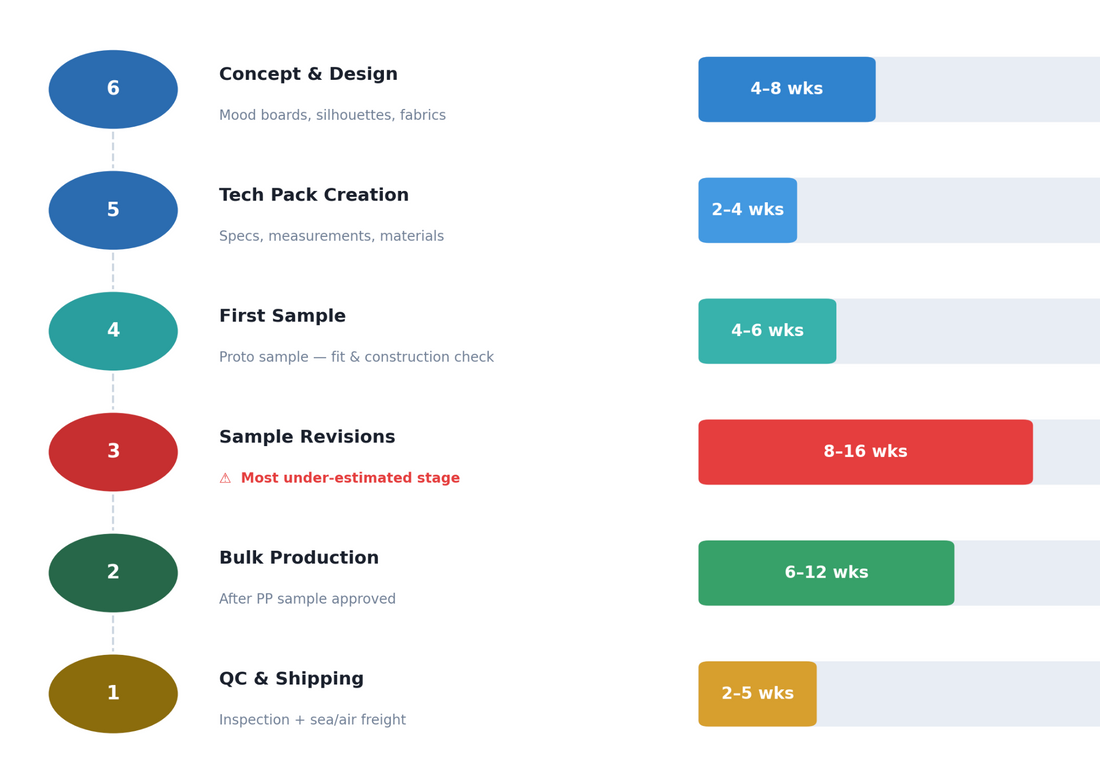

The 6 Stages of Clothing Production (With Real Timelines)
Here is a realistic look at the process from the first sketch to the final product.
Stage 1: Concept & Design Development (4–8 weeks)
This involves mood boards, fabric research, and colorway decisions.
Common mistake: Brands rush this stage, leading to endless (and costly) sample revisions later.
Stage 2: Tech Pack Creation (2–4 weeks)
A tech pack is the blueprint your factory uses to build your garment. Without it, factories are just guessing.
- Pro Tip: A professional tech pack reduces revision rounds, saving you 2–3 weeks in sampling.
- 👉 [How to Create a Tech Pack for Your Clothing Brand]
Stage 3: First Sample / Proto Sample (4–6 weeks)
The factory produces a prototype to check construction and fit. At this stage, you are looking for structural accuracy, not perfection.
Stage 4: Sample Revisions (6–16 weeks)
This is where most timelines fall apart. You will typically go through:
- Salesman Sample (SMS): Corrected construction and actual fabrics.
- Pre-Production Sample (PP Sample): The final sign-off before bulk begins.
- Top of Production (TOP) Sample: To confirm consistency of the bulk run.
Stage 5: Bulk Production (6–12 weeks)
Bulk production only begins after PP sample approval.
- Small runs (200–500 units): 6–8 weeks.
- Large runs (1,000+ units): 10–12 weeks.
Stage 6: Quality Control & Shipping (2–5 weeks)
Before goods leave, an AQL inspection should occur to ensure quality.
- Sea freight: 3–5 weeks.
- Air freight: 5–10 days (significantly more expensive).
- 👉 [AQL Quality Control: A Brand Founder's Guide]
A Realistic Production Calendar Summary

Launch Targets vs. Start Dates
- Spring/Summer (March–May): Start July–September of the prior year.
- Fall/Winter (September–November): Start January–March of the same year.
- Holiday (November–December): Start February–April of the same year.
3 Timing Mistakes That Sink Collections
- Confusing Production Time with Lead Time: The factory saying "production takes 8 weeks" only refers to Stage 5. The total lead time is 3–4x longer.
- Not Budgeting for Revision Rounds: First samples are almost never approved on the first pass. Plan for at least 2–3 rounds.
- Missing the Trend Window: If your production slips by 3 months, you're selling "last season" at full price.
How to Build Your Production Calendar (Backwards)
To stay on track, start with your target launch date and subtract:
- Shipping & QC: 4 weeks
- Bulk Production: 8 weeks
- PP Sample Approval: 3 weeks
- Sample Revisions (2 rounds): 10 weeks
- First Sample: 5 weeks
- Tech Pack & Design: 9 weeks
If your calculated start date is already in the past, you need to adjust your launch date immediately.
Partner With a Manufacturer Who Keeps You on Track
At Topology, we build production schedules collaboratively. We ensure you know exactly where your order is and when you need to make decisions to avoid delays.
This article is part of our complete Apparel Production Guide — covering everything from your first sample to bulk manufacturing.
Whether you're launching your first collection or scaling an existing line, we can help you manage the timeline from day one.
- 👉 [How We Work at Topology]
- Ready to map out your production? [Get in touch with our team →]
FAQ: Clothing Production Timeline
1. Can I speed up the production timeline if I’m in a rush?
Yes, but it comes with trade-offs. You can use Air Freight instead of Sea Freight (saving 3–4 weeks) or choose Ready-to-Ship fabrics instead of custom-dyed ones (saving 2–4 weeks). However, rushing the sampling phase is risky and often leads to quality issues.
2. What is the difference between Production Time and Lead Time?
Production Time is strictly the time the factory spends cutting and sewing (usually 6–12 weeks). Lead Time is the total time from your initial design or deposit until the goods arrive at your door, including sampling, revisions, and shipping.
3. Why does sampling take so long?
Sampling involves more than just sewing. It includes sourcing specific materials, factory queueing, and international shipping for each round. On average, each revision round takes 4–6 weeks to complete and review.
4. Do I need a Tech Pack before contacting a factory?
While some factories offer design services, having a professional Tech Pack is highly recommended. It acts as a legal contract for your design. Without it, the timeline often doubles because of constant miscommunications and incorrect samples.
5. What are MOQs and how do they affect my timeline?
MOQ (Minimum Order Quantity) is the smallest amount of a product a factory is willing to produce. High-MOQ orders may take longer to schedule in a factory’s calendar, while Low-MOQ orders might be pushed back in favor of larger clients during peak seasons.
